如何使用 vxe-gantt table 甘特图来实现多个维度视图展示,支持切换年视图、月视图、周视图等,通过 task-view-config 来配置日期轴。

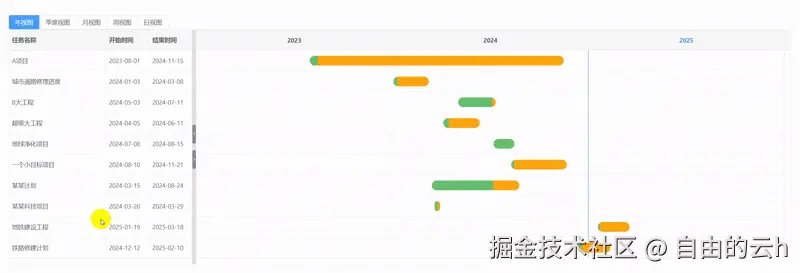

效果
代码
通过 task-view-config.scales 可以灵活的切换显示模式
<template>
<div>
<vxe-radio-group v-model="viewMode" @change="changeViewEvent">
<vxe-radio-button label="1" content="年视图"></vxe-radio-button>
<vxe-radio-button label="2" content="季度视图"></vxe-radio-button>
<vxe-radio-button label="3" content="月视图"></vxe-radio-button>
<vxe-radio-button label="4" content="周视图"></vxe-radio-button>
<vxe-radio-button label="5" content="日视图"></vxe-radio-button>
</vxe-radio-group>
<vxe-gantt v-bind="ganttOptions"></vxe-gantt>
</div>
</template>
<script setup>
import { reactive, ref } from 'vue'
const viewMode = ref('1')
const taskViewConfig = reactive({
scales: ['year']
})
const ganttOptions = reactive({
border: true,
taskBarConfig: {
showProgress: true,
barStyle: {
round: true,
bgColor: '#fca60b',
completedBgColor: '#65c16f'
}
},
taskViewConfig,
columns: [
{ field: 'name', title: '任务名称' },
{ field: 'start', title: '开始时间', width: 100 },
{ field: 'end', title: '结束时间', width: 100 }
],
data: [
{ id: 10001, name: 'A项目', start: '2023-08-01', end: '2024-11-15', progress: 3 },
{ id: 10002, name: '城市道路修理进度', start: '2024-01-03', end: '2024-03-08', progress: 10 },
{ id: 10003, name: 'B大工程', start: '2024-05-03', end: '2024-07-11', progress: 90 },
{ id: 10004, name: '超级大工程', start: '2024-04-05', end: '2024-06-11', progress: 15 },
{ id: 10005, name: '地球净化项目', start: '2024-07-08', end: '2024-08-15', progress: 100 },
{ id: 10006, name: '一个小目标项目', start: '2024-08-10', end: '2024-11-21', progress: 5 },
{ id: 10007, name: '某某计划', start: '2024-03-15', end: '2024-08-24', progress: 70 },
{ id: 10008, name: '某某科技项目', start: '2024-03-20', end: '2024-03-29', progress: 50 },
{ id: 10009, name: '地铁建设工程', start: '2025-01-19', end: '2025-03-18', progress: 5 },
{ id: 10010, name: '铁路修建计划', start: '2024-12-12', end: '2025-02-10', progress: 10 }
]
})
const changeViewEvent = () => {
switch (viewMode.value) {
case '1':
taskViewConfig.scales = ['year']
break
case '2':
taskViewConfig.scales = ['year', 'quarter']
break
case '3':
taskViewConfig.scales = ['year', 'month']
break
case '4':
taskViewConfig.scales = ['year', 'week']
break
case '5':
taskViewConfig.scales = ['month', 'day', 'date']
break
}
}
</script>
